How Much Energy Can a BESS Container Store?
Direct Answer A containerized battery energy storage system can store several megawatt-hours of electricity in one transportable enclosure. TLS currently lists configurable BESS platforms with an energy...
How to Specify a Refrigerated Container for Controlled-Temperature Cargo
Short Summary Specify a refrigerated container from the cargo temperature profile, loading pattern, journey, ambient conditions and handling plan. Confirm the setpoint and allowable excursion, pull-down...
How to Specify a Containerized Data Center for a Remote or Offshore Site
Short Summary A containerized data center should be specified as an operating system, not as a container filled with IT racks. Define the IT load and growth path, availability objective, power architecture,...
The full lifecycle cost of a battery energy storage system (BESS) includes more than the initial equipment purchase. It covers project development, the DC battery system, power conversion, AC equipment, cabling, energy management, construction, grid connection, operation, battery augmentation and final decommissioning.
For an accurate BESS investment analysis, every cost should be assessed over the project’s intended operating life—not simply compared as an upfront cost per kWh.

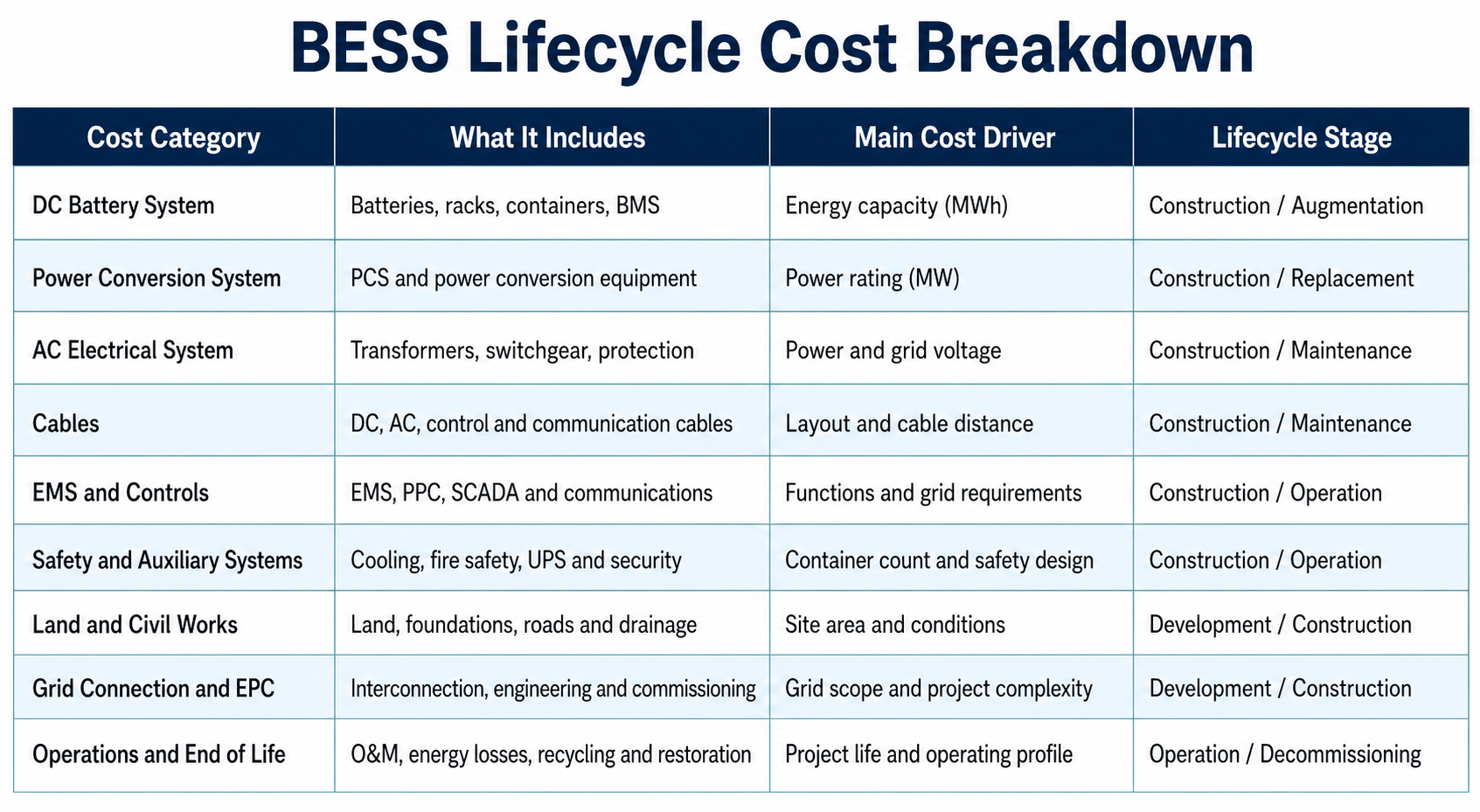

What Are the Main Cost Components of a BESS Project?
1. DC Battery System
The DC side normally includes battery cells, modules, racks, battery containers, battery management systems and DC protection equipment. Its cost is primarily driven by the required energy capacity in MWh, battery chemistry, discharge duration, cycle life and usable state-of-charge range.
For longer-duration projects, the DC battery system is often one of the largest capital cost components.
2. Power Conversion System
The power conversion system, or PCS, converts DC electricity into AC electricity during discharge and AC into DC during charging. PCS cost is mainly related to the project’s rated power in MW.
Efficiency, overload capability, grid-forming functions and reactive power requirements can all affect PCS selection and cost.
3. AC Electrical System
The AC system includes step-up transformers, switchgear, protection, metering and, where required, a main transformer and high-voltage equipment. Costs depend on project power, collection voltage and the voltage at the grid connection point.
4. Cables
A BESS project requires DC cables, low- and medium-voltage AC cables, control cables and communication cables. Cable costs are influenced by system layout, equipment spacing, current rating and the distance between the battery system and the point of interconnection.
5. EMS and Control Systems
The energy management system controls charging, discharging, state of charge and operating schedules. The broader control scope may also include the plant power controller, SCADA, remote monitoring, dispatch interfaces and cybersecurity equipment.
EMS cost depends less on battery capacity and more on the required operating functions, market participation and grid-code compliance.
6. Thermal Management, Fire Safety and Auxiliary Systems
Battery cooling, fire detection, fire suppression, ventilation, auxiliary power, UPS, lighting, security and grounding are essential supporting systems. Their design affects safety, availability, energy consumption and long-term maintenance costs.
7. Land and Civil Works
Land costs may include purchase, lease payments, taxes and permitting. Civil works can include site preparation, equipment foundations, roads, drainage, fencing, cable trenches and control buildings.
These costs vary significantly by location and site condition.
8. Grid Connection and Project Delivery
Grid connection costs may include interconnection studies, transmission lines, substations, utility upgrades and grid-side equipment. Engineering, procurement and construction costs cover design, installation, commissioning, project management and testing.
Development fees, insurance, financing costs, taxes and contingency allowances should also be included in the initial investment.
What Costs Occur During BESS Operation?
Operating costs include preventive maintenance, spare parts, system monitoring, software support, insurance, land rent and auxiliary electricity consumption.
Battery degradation is another major lifecycle consideration. Depending on operating conditions and performance guarantees, additional battery capacity may be installed during the project life. PCS units, cooling equipment, sensors and control hardware may also require repair or replacement.
Charging energy and efficiency losses should not be ignored. The project must purchase or generate more electricity than it ultimately delivers because some energy is lost in the batteries, PCS, transformers, cables and cooling systems.
At the end of the project, costs may include equipment removal, battery transport, recycling and site restoration. Recoverable materials and equipment residual value can partially offset these expenses.
How Should BESS Lifecycle Cost Be Evaluated?
Projects should be compared using total cost of ownership and levelized cost of storage, not equipment price alone. The comparison should use the same MW rating, usable MWh capacity, operating life, annual cycling profile, efficiency, availability and end-of-life capacity requirement.
A lower initial price does not always produce the lowest lifecycle cost. System efficiency, degradation, maintenance requirements and integration quality often determine the project’s real long-term economics.
Frequently Asked Questions
What is usually the largest BESS cost component?
For many projects, it is the DC battery system. However, grid connection, civil works and high-voltage equipment can be substantial for complex sites.
Should battery replacement be included?
Yes. Battery augmentation or replacement should be modelled according to expected degradation and the contracted capacity guarantee.
Why is cost per kWh alone insufficient?
It excludes power equipment, grid connection, operating costs, efficiency losses, financing and end-of-life obligations.
