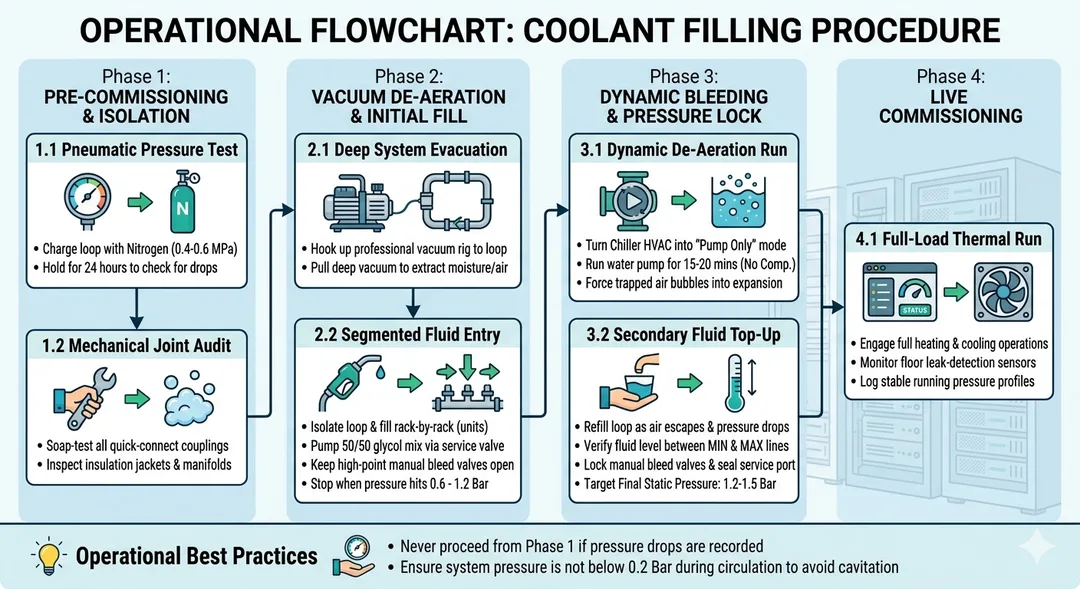

Initial coolant filling is a critical commissioning milestone for liquid-cooled Battery Energy Storage Systems (BESS). Improper execution can cause severe airlocks, localized cell overheating, or catastrophic fluid leaks. Operators must strictly adhere to this standardized six-step protocol to ensure long-term thermal management reliability.

1. Pre-Check and Pressure Testing
  • Leak Detection: Conduct a 24-hour nitrogen pressure holding test (typically at 0.4–0.6 MPa) before introducing any liquid.
  • Joint Inspection: Verify all quick-connect couplings, manifold joints, and thermal insulation jackets are fully secured.
  • Media Verification: Confirm the coolant spec matches requirements (e.g., 50/50 premixed ethylene glycol and deionized water).
2. Deep System Evacuation
  • Airlock Prevention: BESS piping is extensive; filling at atmospheric pressure guarantees trapped air.
  • Vacuum Pull: Connect a heavy-duty vacuum pump to seal off the loop. Pull a deep vacuum to remove all moisture and air pocket potential.
3. Segmented Initial Injection
  • Cluster Isolation: Open valves grouping by grouping (or rack by rack) to ensure uniform fluid distribution.
  • Priming Fluid: Pump coolant into the low-point service valve until the pressure gauge reads a stable 0.6 to 1.2 Bar.
  • Bleeding Valves: Keep high-point manual bleed valves cracked open until a steady stream of fluid—free of foam—emerges.
4. Dynamic Circulation & De-Aeration
  • Pump Control: Power on the BESS Chiller/HVAC unit in "Manual Circulation Mode" (run the pump only; keep the compressor off).
  • Air Expulsion: Circulate the fluid for 15–20 minutes to force micro-bubbles out of the cold plates and into the expansion tank.
  • Pressure Monitoring: Watch for pressure drops as trapped air is displaced by the moving fluid.
5. Secondary Top-Up & Stabilization
  • Final Pressure Adjustment: Top up the system until the static pressure locks firmly between 1.2 and 1.5 Bar.
  • Level Check: Ensure the expansion tank sight glass reads precisely between the MIN and MAX thresholds.
  • System Sealing: Securely lock all manual bleed valves and disconnect the external filling rig.
6. Full-Load Commissioning
  • Active Thermal Run: Engage full heating and cooling modes to run the system under simulated operational stress.
  • Leak Detection: Monitor the container floor leak-detection cables and bilge level sensors for any moisture alarms
